Back to BlogRenovation
Avoid Chaos: Your Complete Renovation Roadmap

Home PlannerApp Team · August 22, 2026
Renovating an apartment without finishing? This detailed renovation timeline and construction materials checklist is designed for spaces up to 100m².

Notes:
- This is a generalized renovation roadmap suitable for spaces without finishing (bare shell).
- Always check local building regulations and adapt timelines to your contractor's availability.
- Material delivery should be planned in advance for each stage to avoid delays.
- Use Home Planner to create your layout, annotate socket locations, and export PDF reports for your contractor.

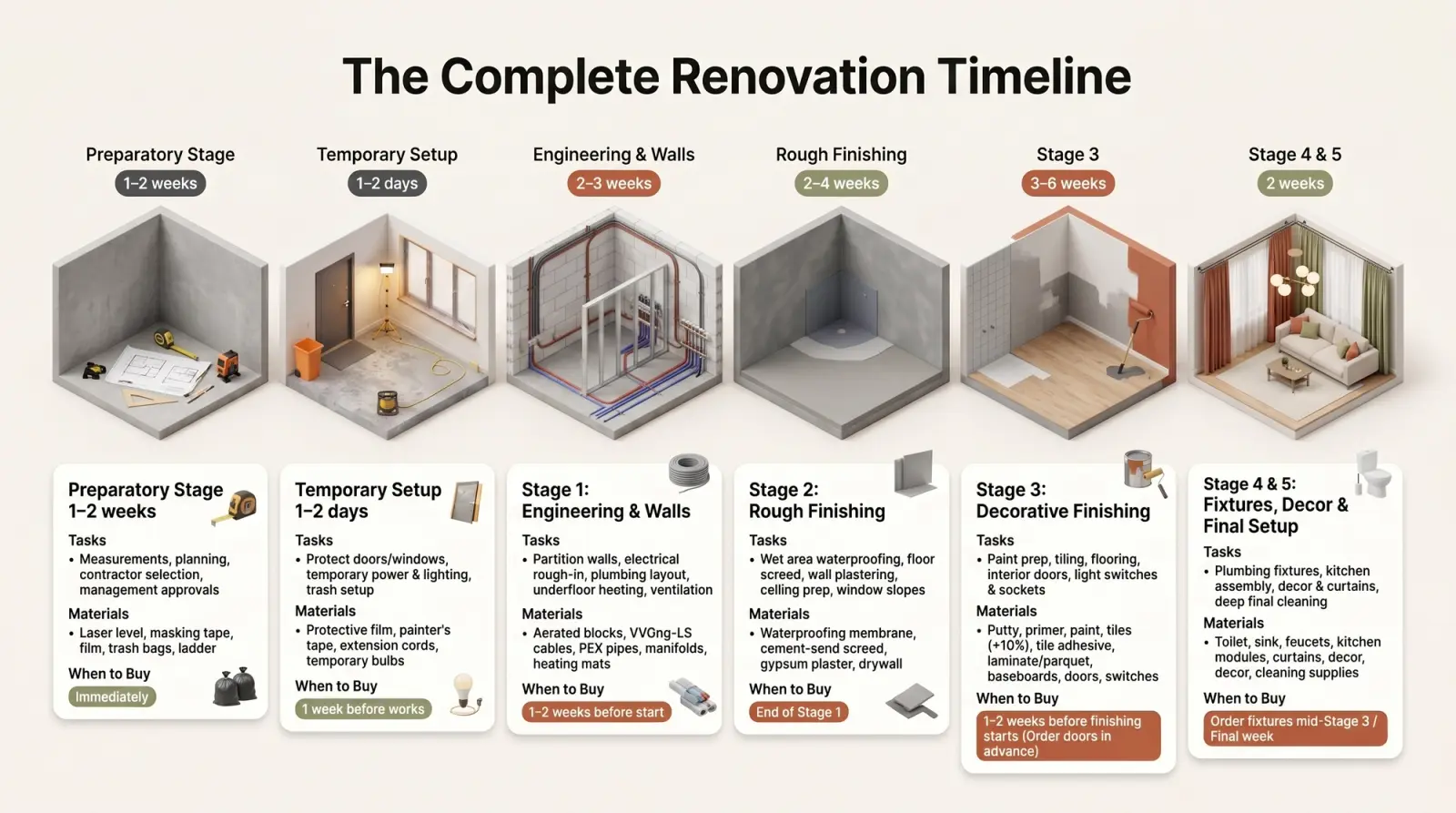

| Stage | Duration | Key Tasks | Materials to Prepare | When to Buy |
|---|---|---|---|---|
| Preparatory Stage | 1–2 weeks | Measurements, planning, approvals, contractor selection | Laser level, angle ruler, level, masking tape, gloves, buckets, film, trash bags, ladder, notebooks | Immediately |
| Furniture & layout planning, socket & light planning | Home Planner app, tape measure, sketch paper, planning software | Immediately | ||
| Get 2–3 contractor quotes, sign contract | Contractor contract template, project folder, quote comparison sheet | Week 1 | ||
| Get approval from building management | Application form, noise schedule, garbage removal plan | Week 1 | ||
| Temporary Setup | 1–2 days | Protect entry door and windows | Protective film, painter's tape, cardboard or plastic sheets | 2–3 days before works |
| Temporary lighting and sockets | Extension cords, temporary fixtures, LED bulbs | 1 week before works | ||
| Temporary toilet, garbage handling | Toilet rental, garbage bags, dumpster rental | 1 week before works | ||
| Stage 1: Engineering & Walls | 2–3 weeks | Partition wall construction | Aerated concrete blocks, tongue-and-groove slabs, adhesive mortar, mesh, beacons, primer | 1–2 weeks before start |
| Electrical rough-in | Cables (VVGng-LS), PVC corrugated pipes, boxes, circuit breakers, RCDs, distribution panel, mounting tape | 1–2 weeks before start | ||
| Plumbing layout | PEX or PP pipes, fittings, shut-off valves, tees, collector box, filters, sound insulation | 1–2 weeks before start | ||
| Underfloor heating installation | Heating mats or water pipes, thermostat, insulation underlay, sensor conduit, clips | 1–2 weeks before start | ||
| Ventilation and heating systems | Ducts, grilles, valves, radiators, brackets, pressure testing tools | 1–2 weeks before start | ||
| Stage 2: Rough Finishing | 2–4 weeks | Waterproofing wet areas | Waterproofing compound, tape for corners, roller/brush, primer | During Stage 1 |
| Screed and leveling | Cement-sand mix or ready screed, mesh, beacons, damper tape, primer, plastic sheeting | End of Stage 1 | ||
| Wall plastering | Gypsum or cement plaster, metal corners, deep primer, trowels, buckets | End of Stage 1 | ||
| Ceiling prep | Drywall, joint compound, putty knife, mounting rails | End of Stage 1 | ||
| Install slopes and seal window gaps | Foam sealant, putty, paintable caulk | During Stage 2 | ||
| Stage 3: Finishing | 3–6 weeks | Paint prep & wall finishes | Putty (start + finish), primer, paint, rollers, tape, trays | 1 week before finishing starts |
| Tile work (bathroom/kitchen) | Tiles (+10%), tile adhesive, spacers, grout, decorative trims, waterproofing layer | 1–2 weeks before | ||
| Flooring | Laminate/parquet/vinyl, underlay, thresholds, trims, baseboards | 1–2 weeks before | ||
| Install doors | Door panels, jambs, handles, locks, seals | Order in advance | ||
| Install switches, sockets, lights | Electrical fixtures, LEDs, frames, dimmers | During finishing | ||
| Stage 4: Fixtures & Decor | 2 weeks | Install bathroom and laundry fixtures | Toilet, sink, vanity, faucet, washing machine, valves | Order mid-Stage 3 |
| Kitchen assembly and installation | Cabinet modules, countertop, sink, stove, hood | Order mid-Stage 3 | ||
| Hanging curtains, decor setup | Curtain rods, curtains, lighting, shelves, mirrors, art, rugs | Final week of finishing | ||
| Stage 5: Final Cleaning & Checks | 2–3 days | Deep cleaning, systems check, final punch list | Vacuum, mop, sponges, touch-up paint, sealant, instruction manuals | Final week |
